Projects
C-423 Fluted Rock Road
Kin Dah Lichi’i, AZ – Road project took place March 12, 2020 – June 4, 2020. 1.3 miles was improved.
Improvements to C-423

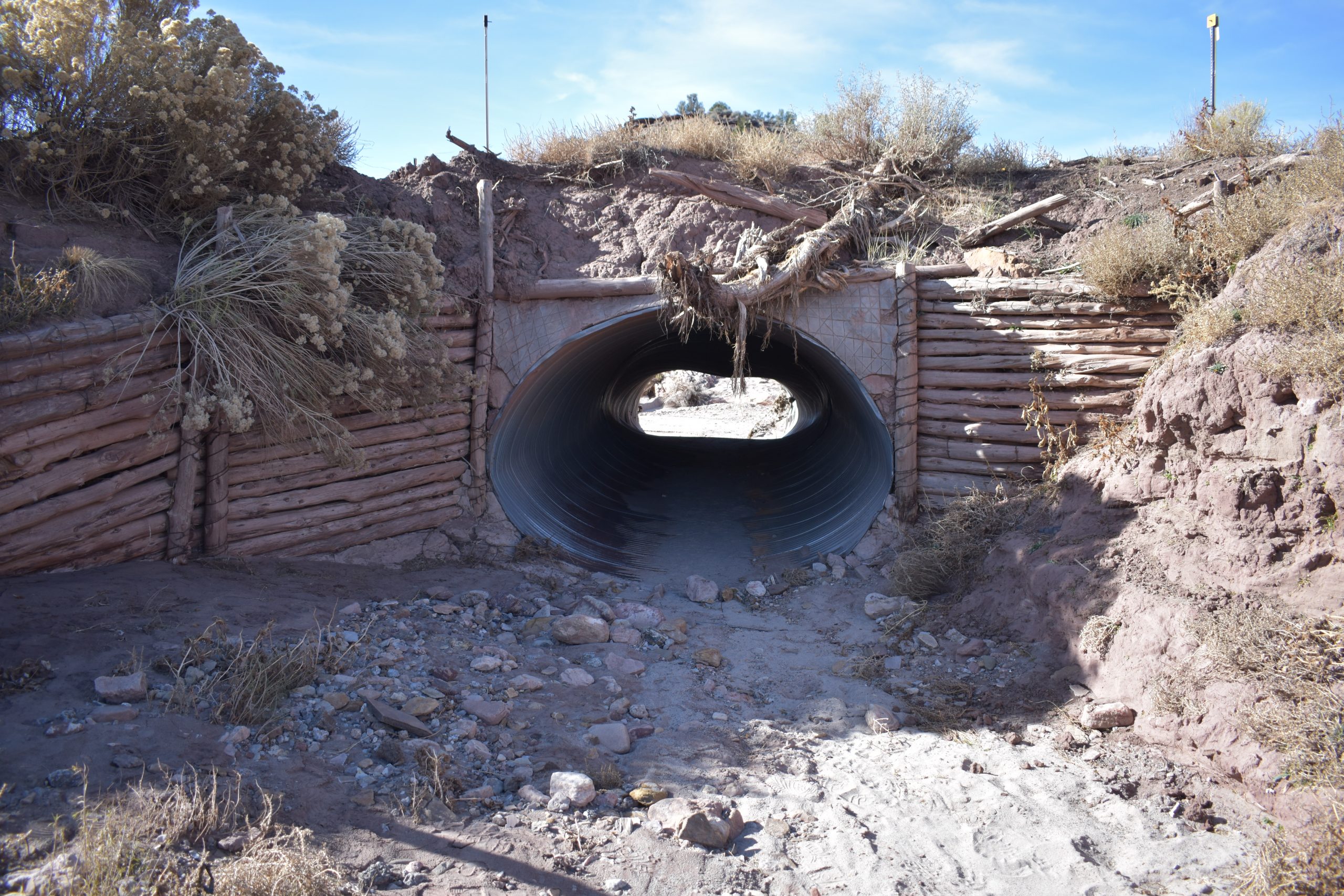

Culvert Cleaning.
Cut and shape drainage.
Sub-grade preparation.
Grade & Re-shape road.
Limestone placement.
Soil Stabilizer applied.
C-415 Mountain Loop Road
Cornfields, AZ – Road project took place April 13, 2020 – May 20, 2020. 1.2 miles was improved.
Improvements to C-415
Culvert Cleaning.
Sub-grade preparation.
Grade & Re-shape road.
Limestone placement.
Soil Stabilizer applied.
C-321 Gray Cactus Road
Tsaile, AZ – Road project took place March 2, 2020 – April 22, 2020. 1.5 miles was improved.
Improvements to C-321
Culvert/Drainage Ditch Cleaning.
Sub-grade preparation.
Grade/Re-shape road.
Limestone placement.
Soil Stabilizer applied.
C-429 South Balakai Road
Steamboat, AZ – Road project took place March 2, 2020. 1.0 miles was improved.
Improvements to C-429 South
Culvert/Drainage Ditch Cleaning.
Sub-grade preparation.
Grade/Re-shape road.
Limestone placement.
Soil Stabilizer pending.
C-302 Baldwin Road
Houck, AZ – Road project took place February 12, 2020 – May 5, 2020. 1.7 miles was improved.
Improvements to C-302
Culvert Cleaning.
Sub-grade preparation.
Limestone placement.
Soil Stabilizer applied.
C-296 Fort Defiance Road
Fort Defiance, AZ – Road project took place November 2019 – April 29, 2020. 0.6 miles was improved.
Improvements to C-296
Culvert Cleaning.
Sub-grade preparation.
Limestone placement.
Soil Stabilizer applied.
C-301 Silversmith Road
Houck, AZ – Road project took place September 9 – October 2019. 2.1 miles was improved.
Improvements to C-301
Culvert Cleaning.
Sub-grade preparation.
Limestone placement.
Soil Stabilizer applied.
N-9056 Besh Bi Toh Road
Jeddito, AZ – Road project took place July 29, 2019 – August 5, 2019. 3.0 miles was improved with the partnership of the Navajo Division of Transportation.
Improvements to N-9056
Culvert Cleaning.

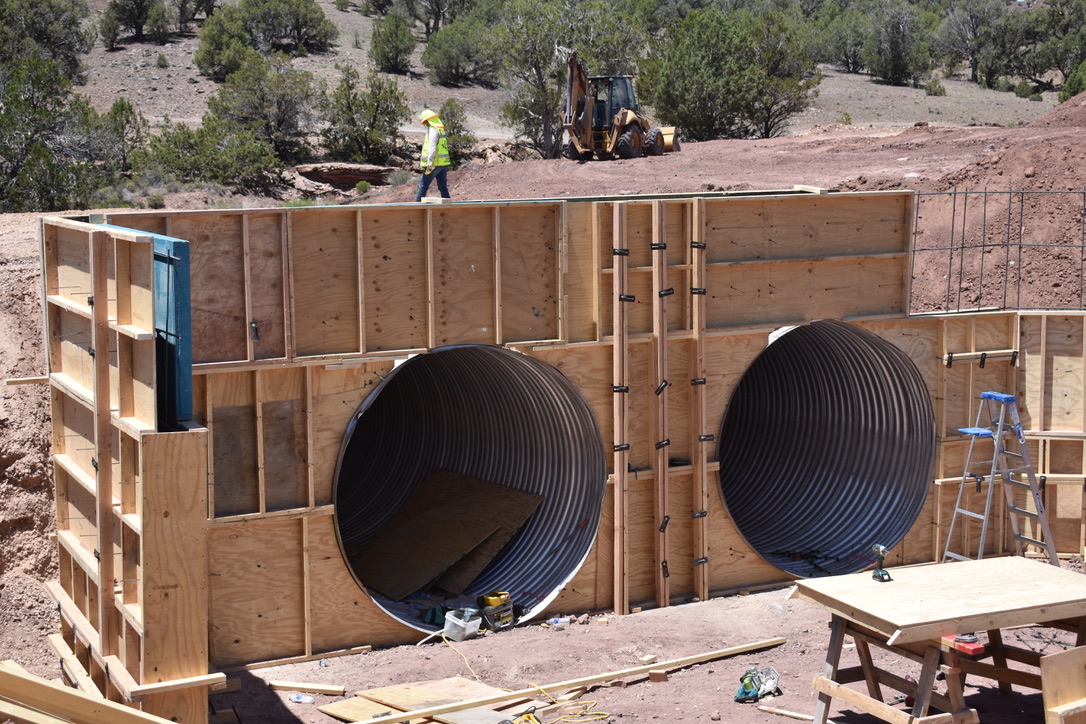

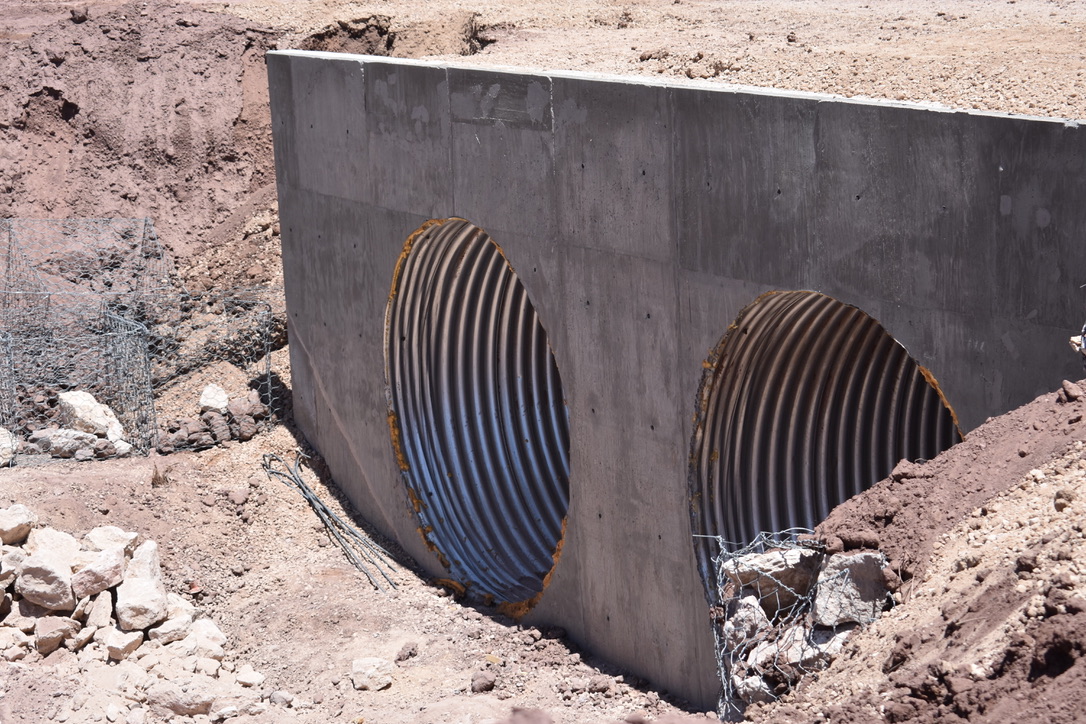

Culvert Installation.
Limestone Build-up.
Dura-Blend applied.
C-273 Black Rock Acres Road
Fort Defiance, AZ – Road project took place March 7 – April 16, 2018. 1.0 miles was improved.
Improvements to C-273
Water Drainage Improved.
Unnecessary Limestone ripped.
Chip Seal applied.
Speed Bumps Installed.
C-455 MP-2 Blue Canyon Road
Fort Defiance, AZ – Road project took place October 31, 2017 – December 30, 2017. 4.6 miles was improved.
Improvements to C-455
Culvert Cleaning.
Culvert Installation.
Limestone Build-up.
Dura-Lock applied.
N-203 Kin Dah Lichi'i Olta Road
Kin Dah Lichi’i, AZ – Partnership road project took place July 27 – October 11, 2017. 2.6 miles was improved.
Improvements to N-203
Culvert Cleaning.
Limestone Build-Up.
Soil Stabilizer applied.
C-429 North Balakai Road
Steamboat, AZ – Road project took place May 8, 2017 – July 1, 2017. 3.0 miles was improved.
Improvements to C-429
Culvert Cleaning.
Culvert Installation.
Limestone Build-up.
Soil Stabilizer applied.

Alton Joe Shepherd
From road maintenance to gathering information from Chapters, we believe being apart of the community is the best way to evolve our services for District 2.
